The global power generation construction pipeline – outside of oil and gas – has reached a scale that would have seemed implausible a decade ago. GlobalData estimates prospective project value at about $8.09tn, spanning wind, solar, hydropower, nuclear, gas and enabling infrastructure. For contractors, equipment suppliers and investors, the figure signals a deep pool of future work. It also demands caution.
The more important number is not the total. It is the stage gate. According to GlobalData, 63.8% of project value remains in pre-planning or planning, while only 22.5% is under execution. That gap is where the market is now being decided – in the practical business of turning permits, grid agreements, finance and procurement into buildable projects.
Discover B2B Marketing That Performs
Combine business intelligence and editorial excellence to reach engaged professionals across 36 leading media platforms.
This is the central tension in the global power generation construction pipeline. The world needs capacity, but capacity is not delivered by aspiration. It is delivered through consenting systems, bankable contracts, credible supply chains and contractors willing to take risk at a price clients can afford. In practice, that is becoming harder.
GlobalData points to sluggish global growth, rising energy and construction costs, and continuing supply chain disruption. These pressures do more than lift budgets. They change behaviour. Contractors build in wider contingencies. Investors scrutinise regulation more closely. Developers place greater value on programme certainty. The cheapest bid is less attractive if it cannot survive contact with inflation, grid delays or a missing transformer.
Renewables dominate, but integration is the real constraint

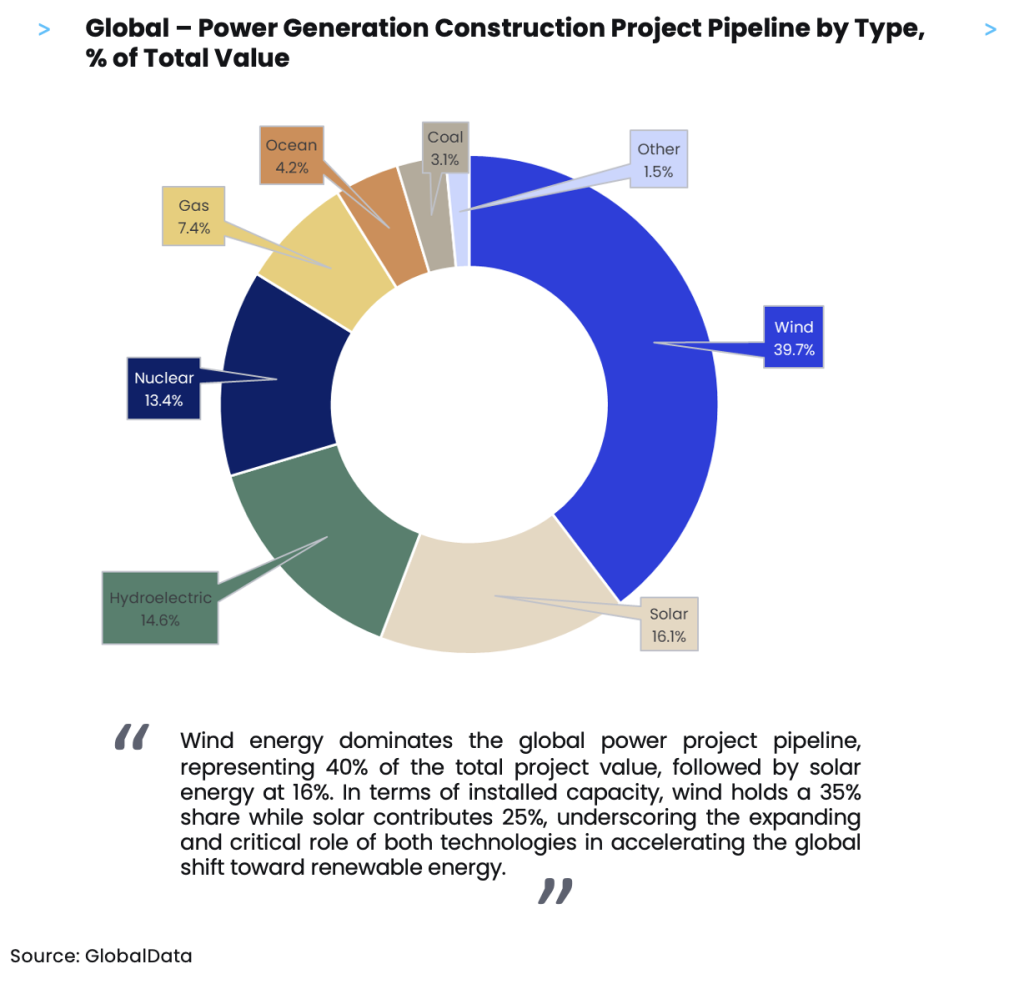

The pipeline is led by renewables. GlobalData puts wind at about 40% of total value, or $3.21tn, with an estimated 1,834GW of new capacity. Solar PV follows at 16%, or $1.30tn, with 1,329GW. Hydropower accounts for 15%, or $1.18tn, and 810GW.
Those numbers confirm the direction of travel, but they do not describe the full construction challenge. Wind and solar are no longer simply generation projects. They are system-integration projects. Their commercial value depends on connection, balancing, dispatch and storage. Without those, capacity becomes stranded, curtailed or less financeable.

The hard problems often appear before construction begins. Land acquisition, environmental review, interconnection agreements and community consent can determine whether a project reaches site at all. For offshore wind, ports, vessels, fabrication capacity and grid reinforcements can shape the programme as much as turbines. For solar, scale brings its own constraints around land, transmission access and local permitting.
Hydropower’s place in the pipeline reinforces the point. Large hydro and pumped storage can provide flexibility and resilience, but they are civil-heavy, politically sensitive and exposed to environmental scrutiny. They can be valuable assets. They are rarely quick wins.
Regional pipelines are moving at different speeds
The global figure hides sharp regional differences. Western Europe leads with a $1.51tn pipeline, according to GlobalData, with offshore and onshore wind making up more than 68% of planned value. The UK contributes $623.1bn, or around 44.4% of the region’s total.
That is a large opportunity, but also a demanding one. Mature markets do not reward optimism for long. Contractors need consenting expertise, supply chain resilience and a record of delivery in regulated environments. Clients, lenders and governments will increasingly ask the same question: can this team actually deliver?
North-East Asia has a different profile. Its pipeline stands at $1.21tn, dominated by China at $860.1bn. GlobalData notes that 62.9% of regional value is already in pre-execution or execution, while China has 711GW in pipeline capacity, including nearly 465.1GW under construction. That matters beyond China. It affects global equipment availability, delivery benchmarks and pricing power.
North America is substantial but less advanced. GlobalData puts the regional pipeline at $759.7bn, with the US at $582.8bn and Canada at $176.8bn. Some 72.54% of projects remain in early development. The risk is lumpiness. If too many projects clear development gates at once, demand for specialist labour, project controls and long-lead components can surge faster than the market can absorb.

Latin America shows the opposite problem: visibility without velocity. Brazil accounts for $580.4bn of a $785.93bn regional pipeline, or 75.2%, but 90.33% of value is still in pre-planning or planning. Early positioning will matter. So will local permitting capability, grid strategy and political risk management.
In the Middle East and Africa, GlobalData tracks $568.1bn in pipeline value, with about 68.1% already in pre-execution or execution. Solar leads, but gas, wind and nuclear remain significant. The near-term opportunity is clearer, yet delivery will depend on governance, financing structures and the ability to manage complex interfaces between generation, grids and industrial demand.
Private capital is raising the bar
GlobalData’s financing split is one of the most commercially important signals in the report. Private investment accounts for 57% of total project value, or about $4.59tn. Public investment represents 25%, or $2.04tn, while PPPs account for 18%, or $1.46tn.
That changes the tone of the market. Private capital can move quickly, but it is selective. It wants risk allocated clearly, contracts that can withstand cost pressure and credible evidence that schedules are achievable. Projects that cannot show that will sit in the pipeline for a long time.
Now, the catch is that many of the hardest risks are not fully within a contractor’s control. Regulation, grid access, political change and supply chain disruption are difficult to price cleanly. That is why policy stability is not a background condition. It is part of project delivery. Indexation, local content rules, guarantees and revenue certainty all shape whether construction can proceed.
The flagship projects cited by GlobalData make the point. Canada’s 3,512MW Darlington refurbishment reflects the rising importance of life-extension programmes, with nuclear-grade quality assurance and long-term workforce planning. Brazil’s proposed 6.5GW Ventos do Sul offshore wind complex shows how scale can run ahead of readiness when environmental review, ports, vessels and grid integration remain unresolved. The UK’s 3,260MW Hinkley Point C remains a test case for firm low-carbon construction in Western markets. China’s planned 60GW Yarlung Tsangpo hydropower project, cited by GlobalData at $167bn, shows how some jurisdictions will pursue energy transition through vast civil infrastructure as much as modular renewables.
The global power generation construction pipeline is therefore more of a filter. It will separate projects with political sponsorship, financial structure and delivery depth from projects that exist mainly as development inventory.
For industry decision-makers, the implication is direct. Contractors need to move earlier, before procurement is formally launched. Investors need to interrogate buildability, not just demand. Developers need to treat grid access, consenting and supply chains as core strategy rather than enabling work.
Extracted and interpreted from a GlobalData report and project-tracking data on global power generation construction pipeline. Figures and examples cited are attributed to GlobalData’s project pipeline insights.
To access the full report, visit the GlobalData Construction Intelligence Centre: www.globaldata.com/industries/construction.
